Bell County East to Big Hill 765-kV Transmission Project
Project Background and Need
In response to unprecedented load growth in the Permian Basin region, LCRA TSC and Oncor are jointly proposing to build and operate a new Electric Reliability Council of Texas-recommended 765-kilovolt transmission line to meet current needs for reliable power and support continuing development and economic growth.
Delivering reliable power to the Permian Basin has been a priority of Texas leaders for several years.
In 2023, the Texas Legislature enacted House Bill 5066, which required the Public Utility Commission of Texas (PUC) to direct ERCOT to develop a reliability plan for the Permian Basin region. ERCOT, after opportunity for stakeholder feedback, published a reliability plan outlining several options for the Permian Basin region in July 2024. The PUC approved the Permian Basin Reliability Plan in October 2024 and in April 2025, ordered 765-kV electric transmission import paths as part of the approved plan.
This project, which is a 765-kV import path project identified in the Permian Basin Reliability Plan, will help extend transmission service to areas where mineral resources have been found, help meet forecast load demands into the future and provide infrastructure to reduce interconnection times in areas without access to transmission service.
In addition to rapid growth in oil and natural gas demand, transmission distribution service providers in ERCOT have also provided demand projections indicating a significant increase in the number of non-oil and gas loads in the Permian Basin region.
Preliminary Routing
The study area for the new transmission line includes portions of Bell, Burnet, Concho, Coryell, Lampasas, Llano, Mason, McCulloch, Menard, Milam. San Saba, Schleicher, Tom Green and Williamson counties. The new line will connect LCRA TSC’s new 765-kV Big Hill Substation planned for Schleicher County (which will be constructed adjacent to LCRA TSC’s existing 345-kV Big Hill Substation) to Oncor’s existing Bell County East Switch in Bell County. The proposed project end points are about 199 miles apart.
LCRA TSC proposes to construct, own and operate the western half of the project (connecting to the new 765-kV Big Hill Substation), and Oncor will construct, own, and operate the eastern half of the Project (connecting to the Bell County East Switch).

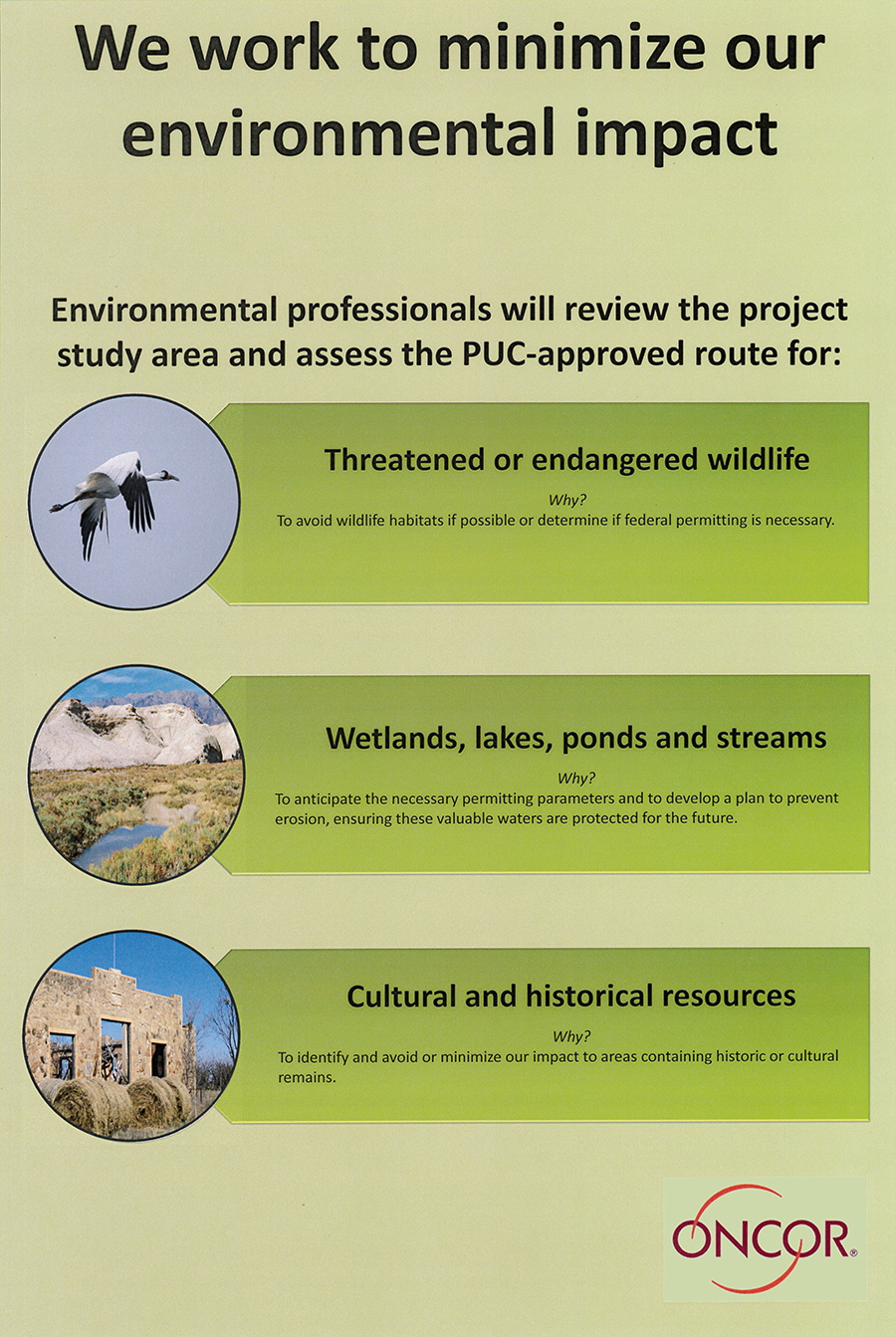

The project requires LCRA TSC and Oncor to amend their certificates of convenience and necessity (CCNs) with the PUC. As part of the process, both utilities will seek input from state and local elected officials and various agencies to identify routing constraints to help determine potential locations for new transmission facilities and assess the project’s potential impacts. LCRA TSC and Oncor held open houses for the public to learn more about the project and provide feedback on the project and the preliminary proposed routing.
Latest Update – June 2025
LCRA TSC and Oncor held project open houses in Salado (June 16), Lampasas (June 17) and Menard (June 18). Interested parties can provide feedback through the project questionnaire.
Below are materials from the meetings:
Estimated Project Timeline
2025 | |
---|---|
January-May | LCRA TSC/Oncor identify preliminary alternative route segments |
April | Public Utility Commission of Texas orders LCRA TSC and Oncor to build 765-kV transmission line |
June | Public open houses: Salado Monday, June 16, 2025, 5-7 p.m. Salado ISD Meadows Room 601 N. Main Street Salado, Texas Lampasas Tuesday, June 17, 2025, 5-7 p.m. Old Middle School Cafeteria 208 E. Avenue B Lampasas, Texas Menard Wednesday, June 18, 2025, 5-7 p.m. Menard County Community Center 303 Travis Street Menard, Texas |
Late fall/winter | Filing of joint application with PUC to amend CCNs |
2026 | |
Winter/early spring | PUC review and processing of application |
Summer | PUC decision and final route determination expected |
2030 | |
Summer | Estimated project in-service date |
Resources
Interactive mapping tool: Zoom in and out on aerial imagery that depicts preliminary alternate transmission line route segments and property line information obtained from the county appraisal district. Note: High-speed internet is recommended.
